Daily Construction Report: Example Format and How to Fill It

The format of a construction daily report: weather, workers, equipment, materials delivered, today’s work and quantities, problems, instructions, safety and photos. How to fill it every afternoon and roll it up into the weekly report.

Komander.ai Panduan team · 2 min read · Updated 9 October 2026

The daily report records what happened on site today. It is simple, but it is the raw material for every other report: the weekly report, the S-curve, site measurements, crew wages, and evidence when there is a delay claim. A regular, consistent daily report is worth more than a polished weekly report written from memory.

Morning: work planMidday: note eventsAfternoon: measure, photosSend before 6 pmWeekly roll-up
How the daily report runs through one working day.

What the daily report contains

SectionExample
Date, project, block23/06/2026, example housing project, block C5
WeatherSunny morning, rain 1 pm to 3 pm
WorkersForeman 1, skilled 6, labourers 8
EquipmentMixer 1, vibrator 1
Materials deliveredCement 40 bags (SJ-131), 10 mm rebar 30 bars
Today’s workIII.1 ground beam pour C5-07 done, 0.9 m3; IV.1 block walls C5-08, 40 m2
Problems10 mm rebar 10 bars short; work stopped 2 hours for rain
Instructions and visitorsThe supervisor asked for wall joints on C5-06 to be redone
SafetyNo incidents; 2 workers without helmets warned
Photos6 photos, named by the naming rule

Filling it in so it is useful

  1. Fill it every working day, even when work stops. Rain days and days waiting for material are important evidence for time extensions.
  2. Write work with the same codes as the budget and schedule, and quantities with units.
  3. Count workers by trade, because this is the basis of wages and productivity.
  4. Record deliveries with the delivery note number, so they can be matched with the store and the PO.
  5. Send it at the same time every day to one person who rolls it up.
  6. At the end of each week, add the daily quantities per work item into weekly progress.
Swipe sideways to see every column →

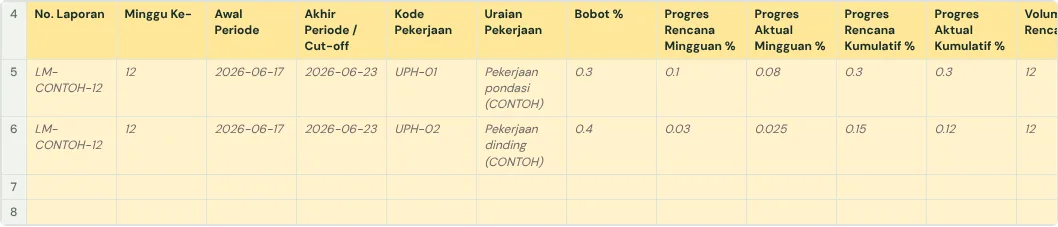

The tab in the free template used for this work, with fictional example rows.
The tab in the free template used for this work, with fictional example rows.

Common mistakes

Start from a template

The full guide is in How to create a weekly construction schedule report in Google Sheets. It has a free template (Excel or Google Sheets) and a checker that reads your own workbook.

Get the templateCheck my workbook

Ready to use the Komander agents on your projects?

When your workbook is complete, apply for a pilot: we help connect your project data to the Finance, Cost and Scheduler agents and review the first reports with you.

Send with GmailEmail app

Send to melwani@komander.ai. Your workbook check result is included when there is one; the workbook itself is not sent.

Common questions

What goes into a daily construction report?

Date, weather, workers, equipment, materials delivered, today’s work and quantities, problems, instructions, safety and photos.

Who writes the daily report?

The site supervisor or foreman, then the project admin or site manager rolls it up.

How does the daily report become the weekly report?

Daily quantities per work item are added into that week’s progress, then compared with the plan.
